Autostrada

Mykolaiv water pipeline
Length:
67.8 km
Daily capacity:
120,000 m³
Irrigation capacity:
+50,000 m³
Personnel:
2,000+
Construction equipment:
1,000+

What caused the problem?

In April 2022, russian forces blew up the Dnipro–Mykolaiv water pipeline in Kherson Oblast, which had supplied Mykolaiv with fresh water. For over three years, the city has been reliant on brackish water from the estuary, which is unfit for consumption.

Impact

01.

Nearly 500,000 residents of Mykolaiv lost access to clean water.

02.

Thousands of hectares of agricultural land are no longer irrigated.

03.

1,200 kilometers of Mykolaiv’s water supply network have been damaged by the brackish water from the estuary.

timeline

04 / 2025
05 / 2025
06/ 2025
07 / 2025
08 / 2025
04 / 2025

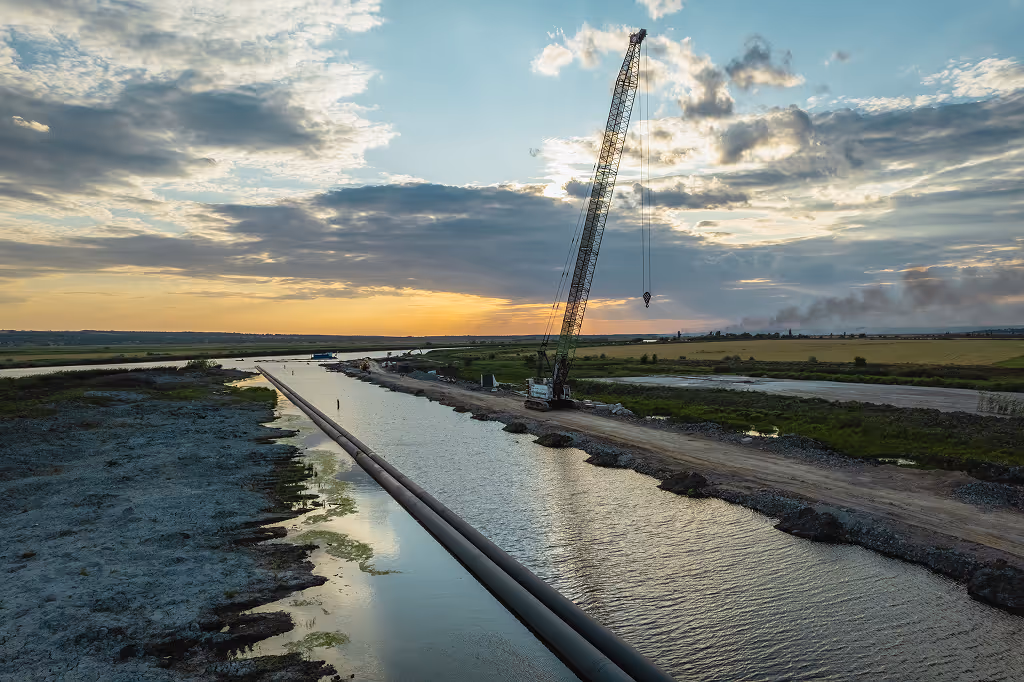

Launch of large-scale earthworks on the new pipeline route

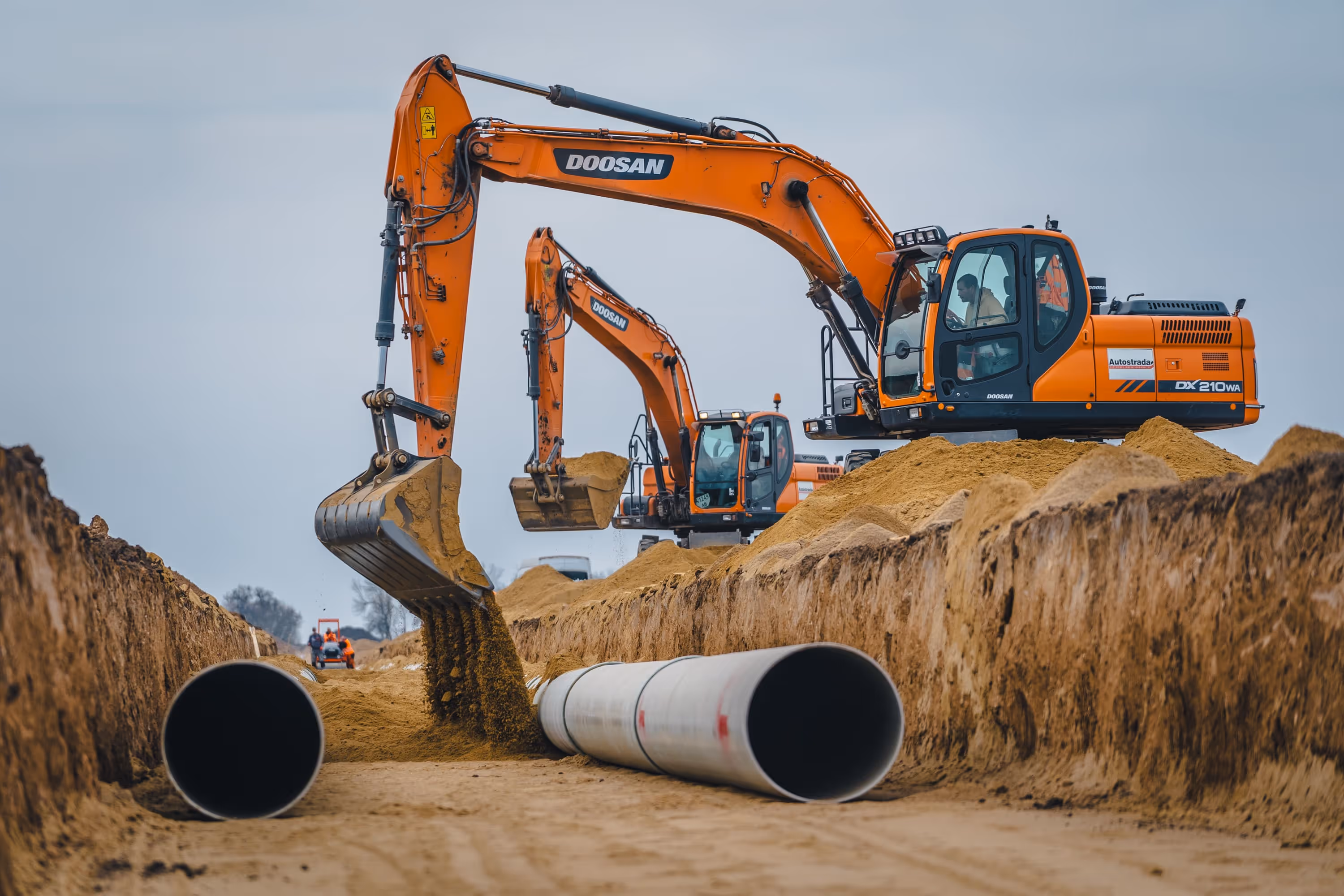

Project implementation is gaining momentum — trench excavation, pipeline base preparation, and delivery of essential materials are underway.Works are carried out around the clock, with strict adherence to all technological requirements.

05 / 2025

Pipeline installation and construction of pumping stations

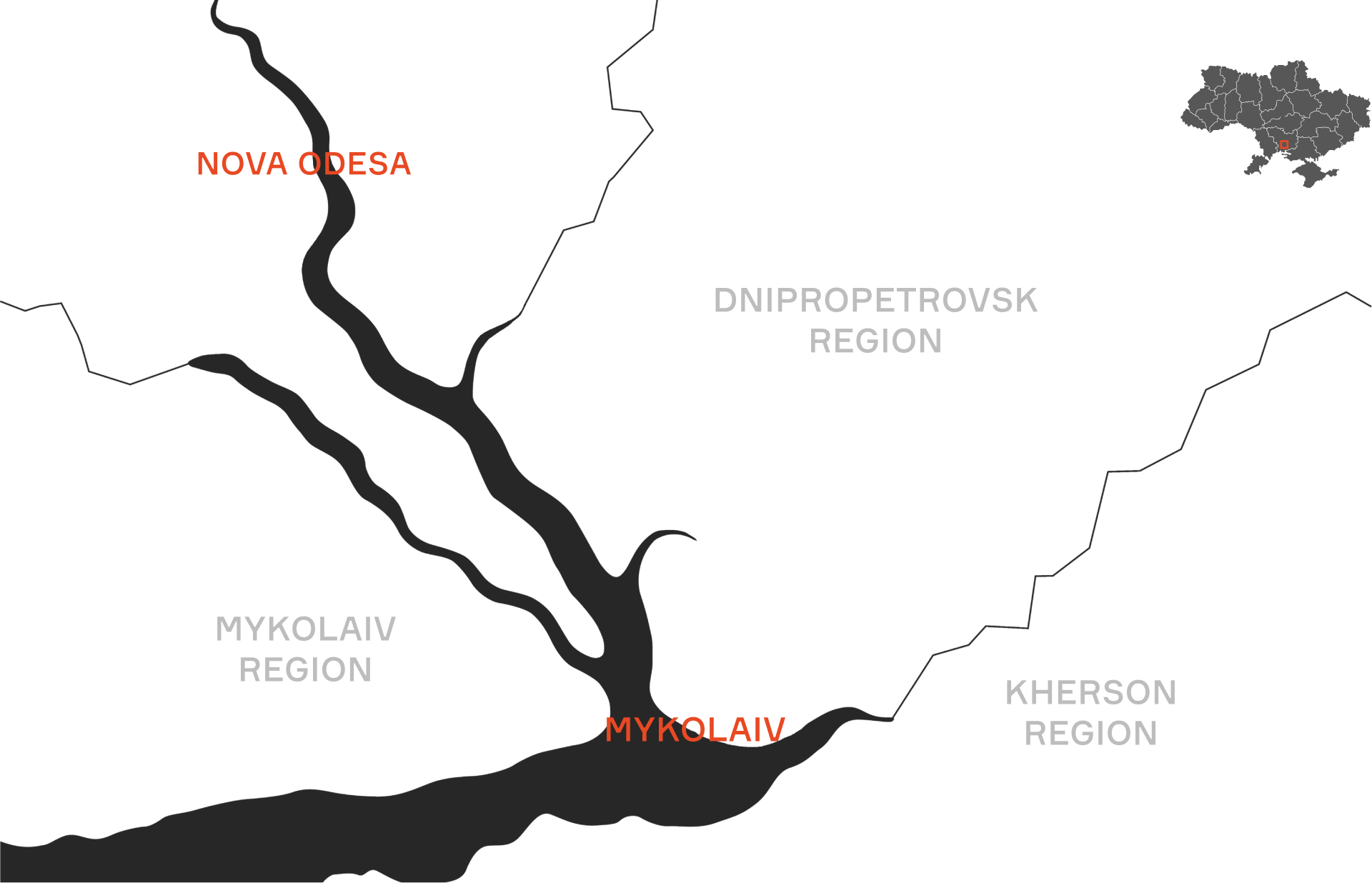

24/7 work continues on the installation of a twin-line pipeline and the simultaneous construction of three pumping stations.Within the intake channel on the Southern Bug River, four branches are being installed to transport water to Pumping Station No. 1 near Nova Odesa.

06 / 2025

Installation of pumping equipment and canal-bed works near Nova Odesa

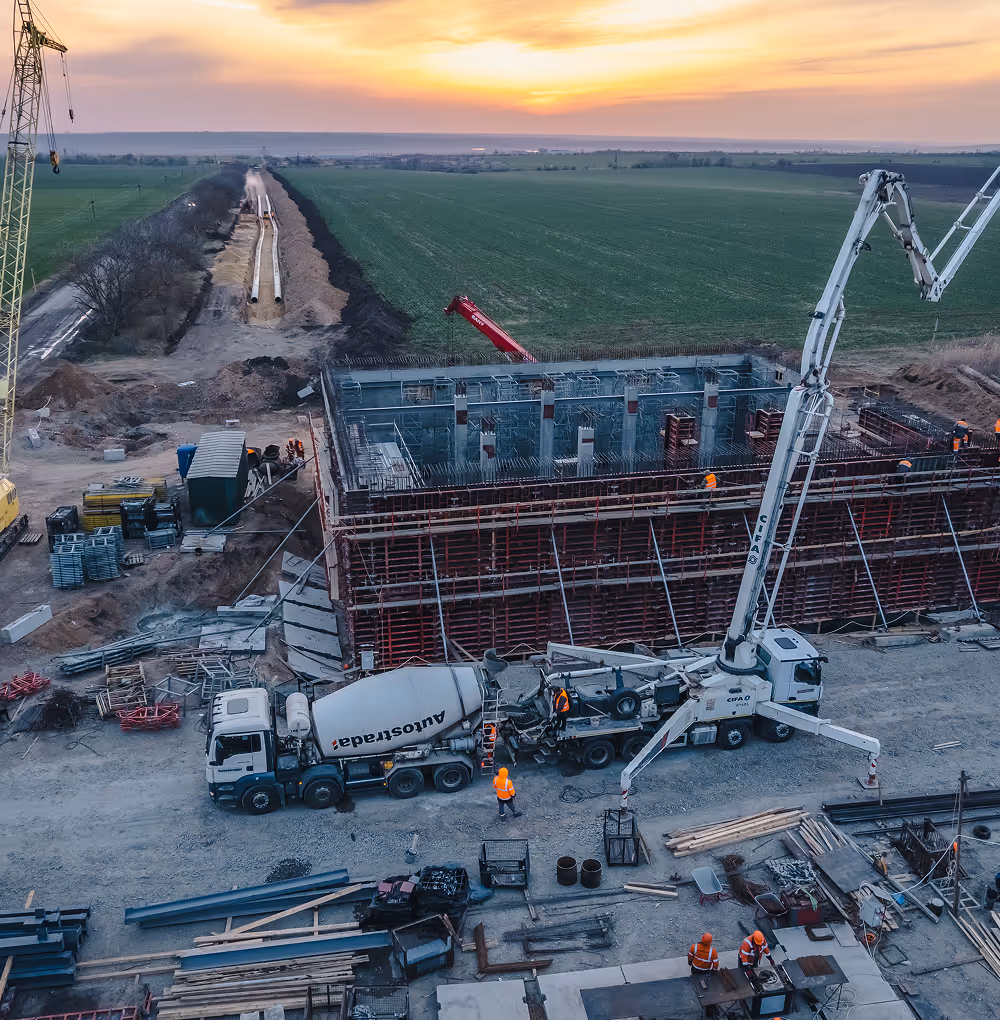

Core construction of the three pumping stations is nearing completion: electrical and pumping equipment has been installed.In the canal bed, a concrete slab foundation was constructed to ensure secure anchoring and stability of the pipelines, followed by backfilling of the intake channel in accordance with project specifications.The next phase — commissioning and system tuning.

07 / 2025

Technical water pumping between pumping stations

As part of commissioning works, specialists test the system under medium operating pressure, verifying sealing, flushing pipelines, and releasing air.Pumping proceeds step by step.At the first stage, water from the Southern Bug flows through gravity pipelines into the intake chambers of Station 1. Once chambers are filled, water is pumped to the second lift station.After pressure reaches target levels, the next segment — from Station 2 to Station 3 — begins to fill.

08 / 2025

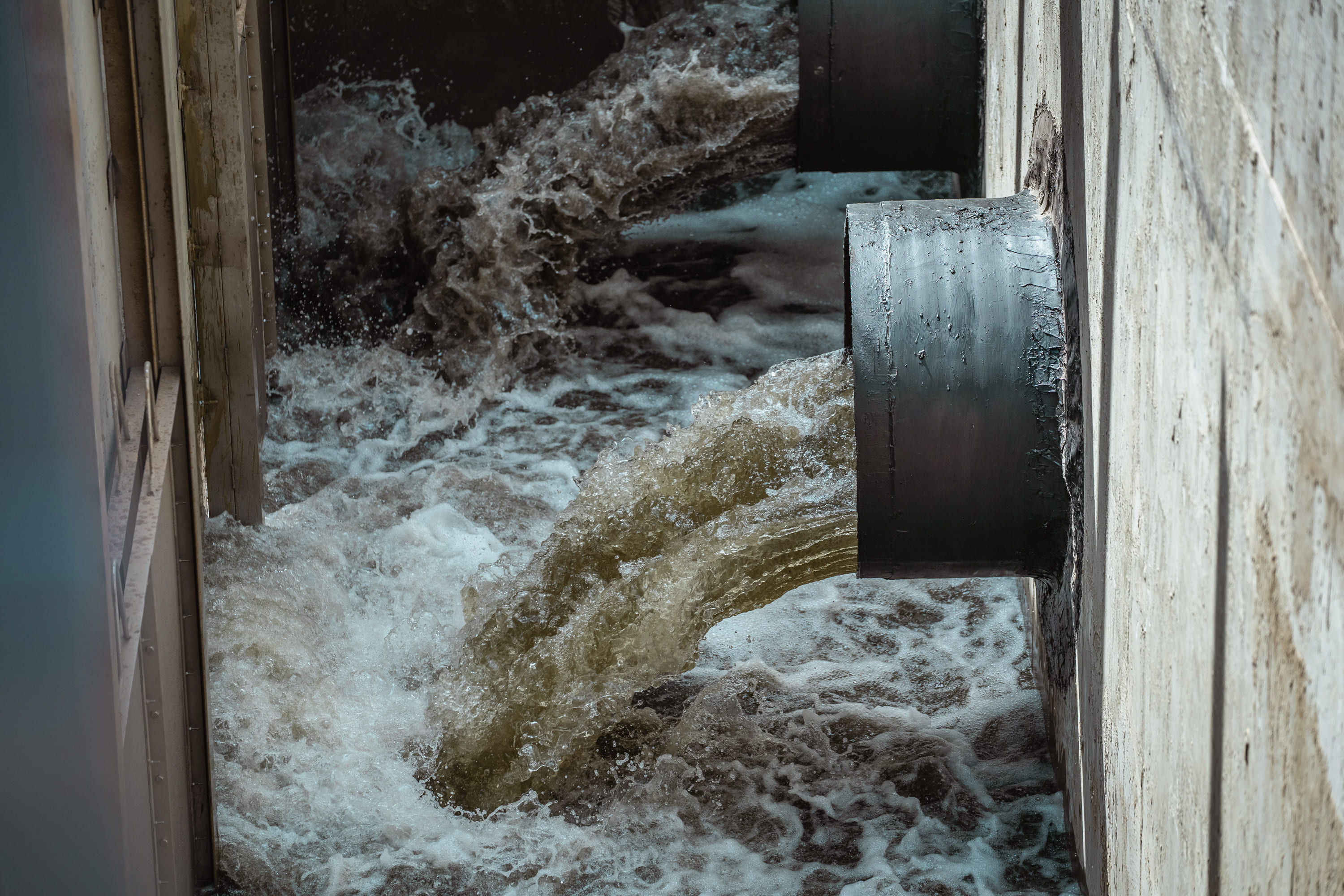

Pipeline commissioning and start of water supply to Mykolaiv

Record-breaking speed

The shortening of timelines became possible thanks to the high competence of the Autostrada team and the availability of the company’s own production facilities, which ensure prompt execution of works. This was further facilitated by the DESIGN&BUILD approach, where designers and builders work in parallel, achieving perfect synchronization of all processes.

5
month

project execution timeline for Autostrada

+2.5
years

the typical timeframe for projects of this kind

100%

Without subcontractors

24/7

Round-the-clock work

Team

Over 2,000 Autostrada specialists are engaged in the project around the clock. Each of them is a vital link in the complex construction mechanism, where the team’s coordinated efforts enable simultaneous work on multiple sections, swift decision-making, and rapid response to any challenges. It is the professionalism and dedication of our experts that have turned an ambitious plan into a tangible reality.

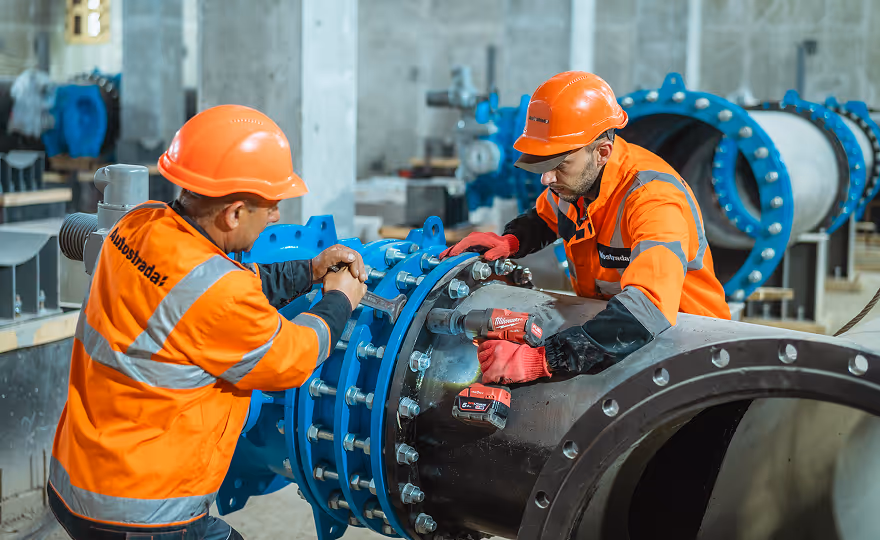

Quality

control

At all stages of the project’s implementation, Autostrada operates its own certified laboratory complexes, ensuring systematic quality control of construction materials and technological processes. This approach guarantees the project’s consistent compliance with national building codes, technical regulations, and European quality standards.

In-house Production Facilities

The availability of in-house production facilities ensures maximum operational efficiency and complete process autonomy.

Asphalt Concrete Plant
Concrete Plant
Soil Mixing Unit
Laboratory Complexes

Savings for the state

This is achieved by performing all work exclusively in-house, without the involvement of subcontractors.

Initial project cost estimate (UAH):
8,7
billion
Final cost through Autostrada’s efficient execution (UAH):
6,2
billion
-25
%

Unique Technologies

The water pipeline route runs outside populated areas. In 20 locations where the route crosses rivers, roads, railways, oil pipelines, and gas pipelines, the horizontal directional drilling (HDD) method is used, enabling installation without damaging the surface or disrupting existing infrastructure. Notably, a unique HDD crossing was executed beneath the bed of the Inhul River. The crossing is 462 meters long, with a depth of 14 meters – equivalent to a four-story building. This method helps preserve the ecosystem and ensures precision in challenging geological conditions.

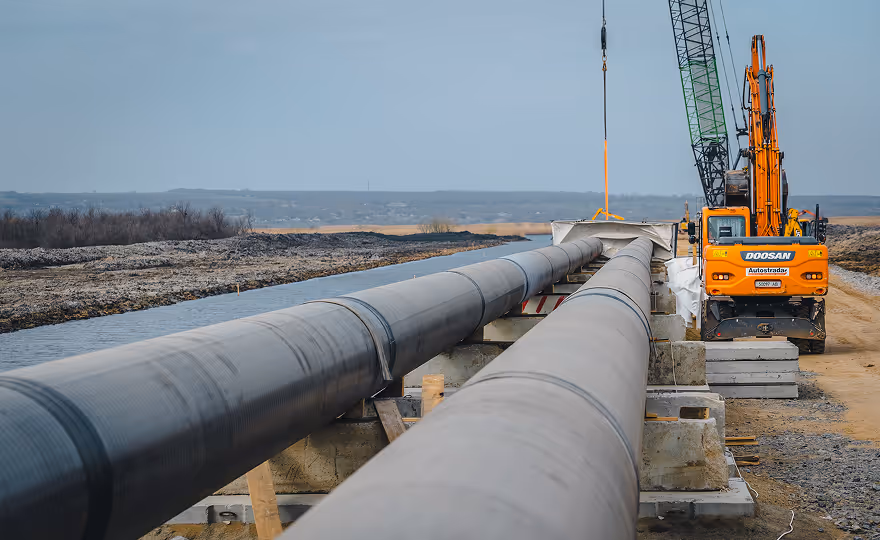

Fiberglass Pipeline

Lightweight
Diameter: 800–900 mm
Pressure resistance: up to 16 atm
Corrosion-resistant
Environmentally friendly
Versatile Application
Withstands soil settlement
Service life: 50+ years

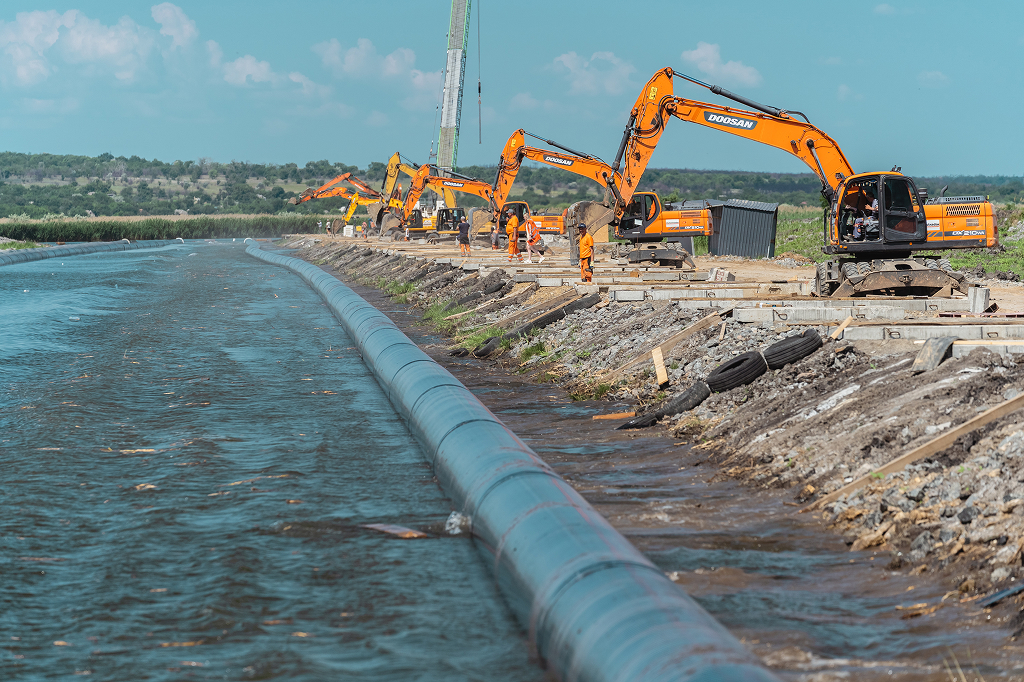

Environmental Standards

The water intake system is equipped with a mechanical pre-filtration complex and an ultrasonic protection system that prevents aquatic bioresources from entering the pipeline.

Pipeline network

The pipeline network includes:

  • 42 air-release chambers (“Vantuz”) to release air from the system
  • 41 drain chambers to discharge water from the system
  • 19 switching chambers to redirect water flow between the pipeline lines
  • 25 shut-off chambers
  • 6 pressure relief chambers
  • 3 chambers equipped with water meters
  • 31 inspection manholes
Water Intake

The water intake project is a unique and complex engineering case.

Since the Southern Bug is a navigable river, the works were carried out without entering the main channel.

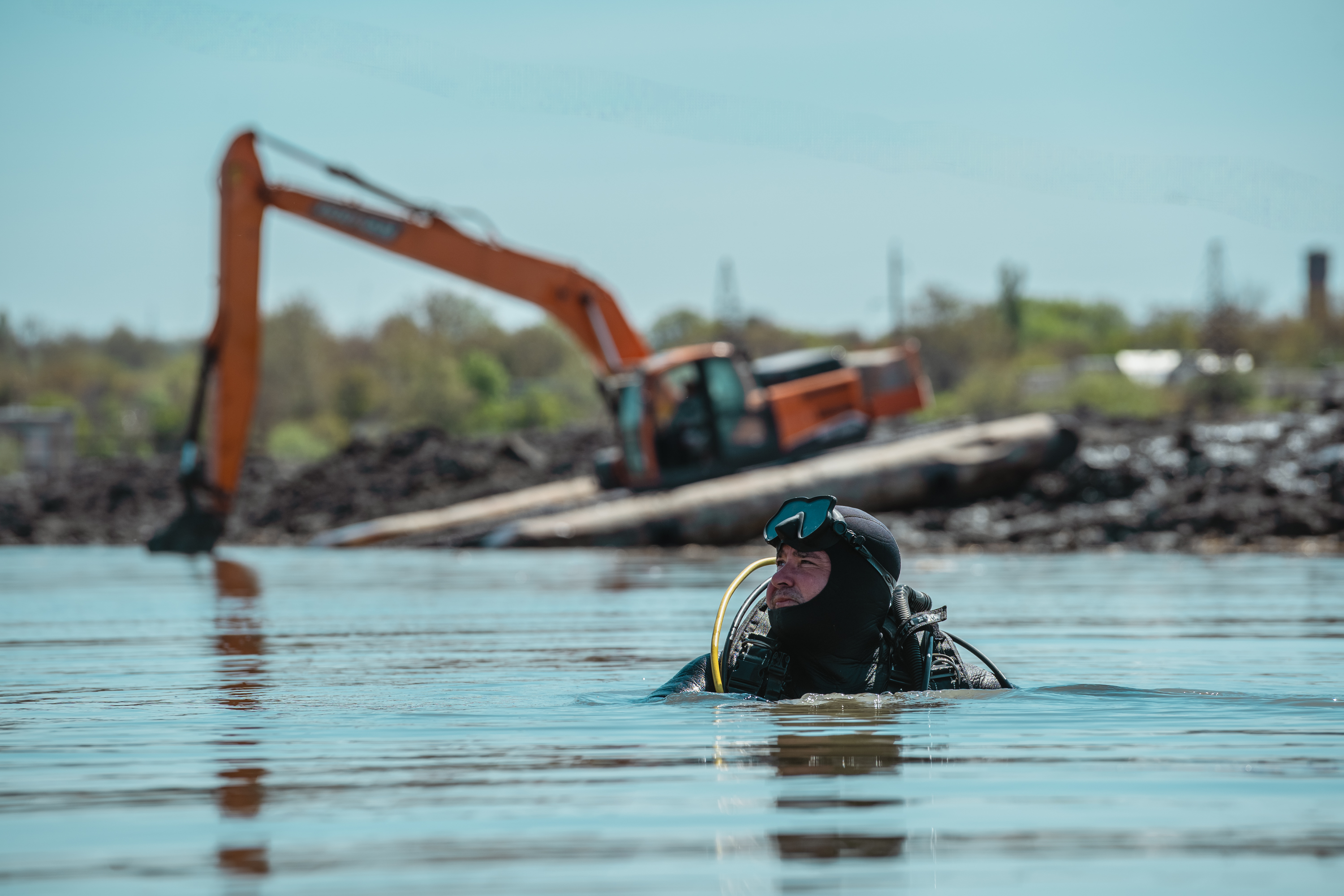

Divers formed the 6-meter-deep intake basin: they reinforced the riverbank with rubble stone, laid concrete slabs, and placed sand-cement bags.

The intake channel was cleared and deepened, and four gravity pipes with a diameter of 1,000 mm and a length of over 700 m were installed.

These pipes ensure the intake, filtration, and transportation of water through three pumping stations to the Mykolaiv water treatment facilities.

Pumping Stations

At BPS No. 1, five pumping units have been installed:

  • Capacity: 2,370 m³/hour
  • Electric motor power: 800 kW

BPS No. 2 and BPS No. 3 are each equipped with four pumping units:

  • Capacity: 2,500 m³/hour
  • Electric motor power: 560 kW
Power Substations

Each station is equipped with a 35 kV switchgear unit and a 35/0.4 kV transformer substation.

Alternative power sources have been installed: diesel generators with capacities of 1,400 kVA and 1,650 kVA.

A total of 39.8 km of cable has been laid underground along the entire pipeline route.

All equipment is housed in monolithic reinforced concrete structures with partial embankment, ensuring reliable protection of the water pipeline’s power system and guaranteeing its uninterrupted operation.

Pumping stations

Three pumping stations have been constructed along the water pipeline route. They are built as monolithic reinforced concrete structures with partial earth embankments, providing an enhanced level of protection against potential shelling. Each station’s premises are equipped with solid concrete shelters to ensure the safe accommodation of personnel.

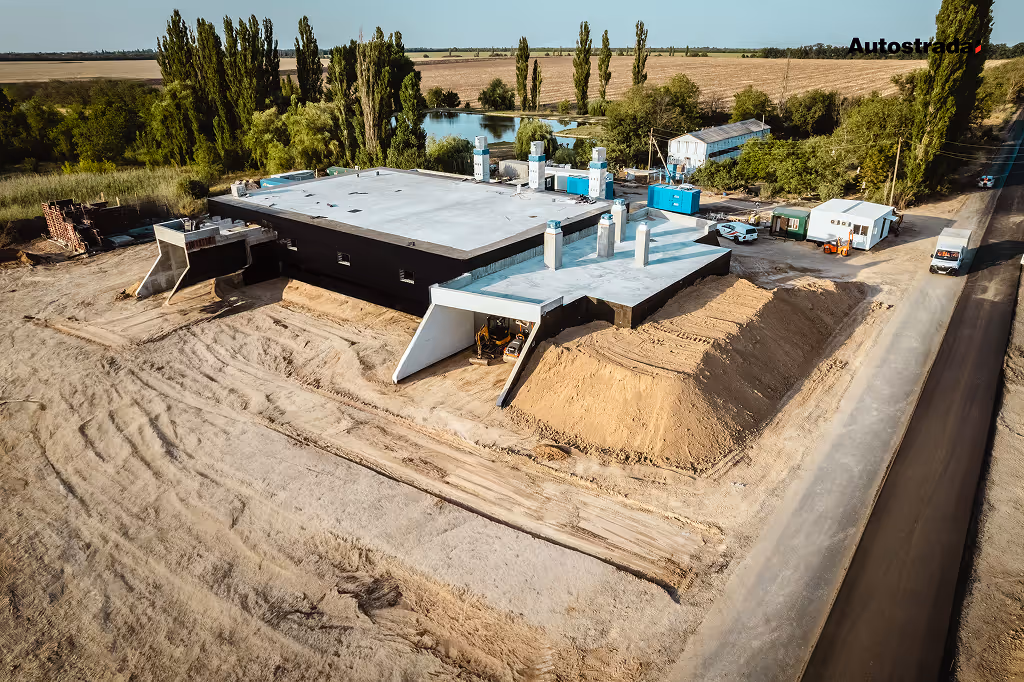

Water treatment facilities

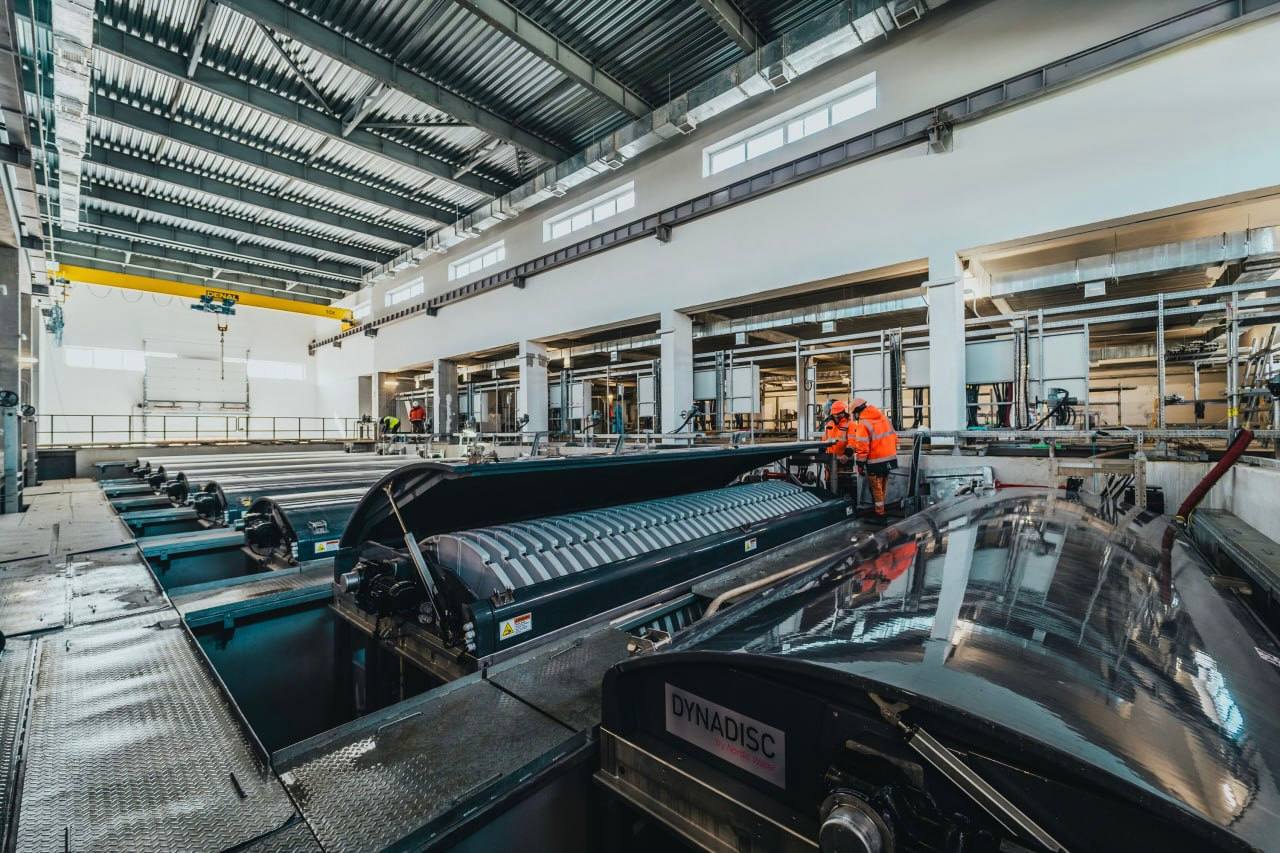

In parallel with the construction of the water pipeline, water treatment facilities are being built to ensure comprehensive water preparation before distribution to consumers.

These facilities will remove mechanical impurities, sand, and silt; disinfect the water from bacteria, viruses, and harmful microorganisms; reduce the content of harmful chemicals and dissolved gases; and improve its taste, odor, and color characteristics.

As a result, the Mykolaiv water supply system will deliver clean, safe, and potable water to consumers.

WE BUILD THE FUTURE OF UKRAINE!
